Utility-scale solar PV design and construction engineering support

An independent power producer and EPC delivery team developing a tracker project on the West Texas High Plains.

Utility-scale solar PV design and construction engineering support
Input received
Boundary, title, wetland and environmental constraint layers, topographic survey and geotechnical basis, module/tracker/inverter/transformer equipment data, and the interconnection agreement's POI voltage, export limit and reactive-power criteria.
Delivered
Tracker-row and equipment layouts, DC/MV single-line diagrams, grounding and trench details, cable and equipment schedules, a BOM/BOQ by block and feeder, and a voltage-drop/ampacity/DC-AC-ratio reconciliation workbook.
Timeline
Eight Pathworks production weeks after approved survey, geotechnical basis, equipment data and interconnection requirements. Excludes client review, utility and AHJ cycles.

One ID-controlled site and electrical model carries a route change through voltage drop, cable length, trench quantities, crossing schedules and drawing references together. The representative design delivers 194.8 MWdc / 150 MWac across 1,120 acres with a 1.299 DC/AC ratio, reduces modeled cable from 550 km to 504 km, and closes 77 of 91 conflicts in the Pathworks coordination register before issue.

PV array
194.8 MWdc
Export capacity
150 MWac
Modeled year-1
405.2 GWh
Cable reduction
8.4%

The engineering problem

The seed layout meets the nameplate target but does not yet behave as a construction model. Tracker rows cross drainage controls, block boundaries do not align with inverter access, cable routes duplicate trenching, and the original inverter grouping creates uneven collection-feeder loading. The task is to hold the interconnection capacity, DC/AC ratio and energy basis while converting the conceptual layout into controlled equipment, cable, trench, grounding, communications, road and drawing schedules, so every quantity traces back to a spatial feature and every field exception has an owner.

Design parameters and calculation basis

DC nameplate330,200 modules × 590 W = 194.818 MWdc
AC nameplate50 inverter stations × 3.0 MWac = 150.0 MWac
DC/AC ratio194.818 ÷ 150.0 = 1.299
Stringing26 modules/string; 254 strings per block; 12,700 total strings
Land use1,120 acres ÷ 194.818 MWdc = 5.75 acres/MWdc
Energy basis405.2 GWh ÷ 194.818 MWdc = 2,080 kWh/kWdc-year (single-axis tracker; 7.5% bifacial gain on 0.25 ground albedo)
AC capacity factor405.2 GWh ÷ (150 MW × 8,760 h) = 30.8%
Worst modeled drops1.42% DC homerun and 1.71% MV feeder at representative maximum-power conditions

Key design decisions

Fifty equal-capacity inverter blocks are standardized so tracker, electrical, SCADA and BOQ packages share the same work-breakdown structure. Inverter stations are shifted toward cable-weighted block centroids while preserving flood, access, fire and maintenance constraints. Eight MV feeders are balanced by both apparent power and route exposure rather than optimizing length at the expense of ampacity or protection selectivity — each feeder carries approximately 18.8 MVA (≈314 A at 34.5 kV) on 1,000 kcmil aluminum sized with direct-buried derating applied. Road, trench and cable crossings are carried as named schedule events rather than relying on graphical intersections alone.

Design and quantity control

Control itemSeed basisCoordinated basisResult / acceptance
DC blocks50 unequal conceptual areas50 × 3.896 MWdc1.299 DC/AC ratio
DC homeruns458 km426 km7.0% reduction
MV collection92 km78 km15.2% reduction
Total modeled cable550 km504 km46 km / 8.4% removed
Coordination conflicts91 identified77 closed; 14 heldEvery open item has owner and due date

QA steps and evidence

QA gateAcceptance testEvidence / result
CapacityModule, string, block and inverter totals reconcile194.818 MWdc / 150.0 MWac
CableGIS length, schedule length and BOQ length agree504 km modeled total
ElectricalAmpacity and representative voltage-drop limits satisfied1.42% DC / 1.71% MV worst modeled
Civil interfaceRows and trenches clear approved constraints77 conflicts closed; 14 controlled holds
Issue controlDrawings, schedules and BOM carry matching revisionThree formal design releases

Revision record

ReleaseTriggerChange madeControlled outcome
30%Survey and constraint compositeShifted 312 tracker rows; relocated six inverter padsBuildable block geometry established
60%Cable and access optimizationRebalanced feeders; removed 46 km modeled cableVoltage drop and access targets met
IFC supportVendor and EPC reviewUpdated equipment, trenches, schedules and BOQControlled construction support package

Result and calculation trail

The representative design delivers 194.818 MWdc / 150 MWac across 1,120 acres with a 1.299 DC/AC ratio. The coordinated model produces 405.2 GWh of illustrative year-1 energy, reduces modeled DC and MV cable from 550 km to 504 km, and closes 77 of 91 spatial or constructability conflicts before issue.

DC nameplate: 330,200 modules × 590 W = 194,818,000 Wdc. Specific yield: 405,200 MWh ÷ 194,818 kWdc = 2,080 kWh/kWdc-year. AC capacity factor: 405,200 MWh ÷ (150 MW × 8,760 h) = 30.8%. Cable reduction: (550 − 504) km ÷ 550 km = 8.4%.

Pathworks converted a representative 194.8 MWdc tracker concept into a coordinated solar construction model covering site layout, DC and MV collection, single-lines, schedules, trench plans and BOQ, reducing cable routing by 8.4 percent while capacity, access and electrical checks remained controlled.

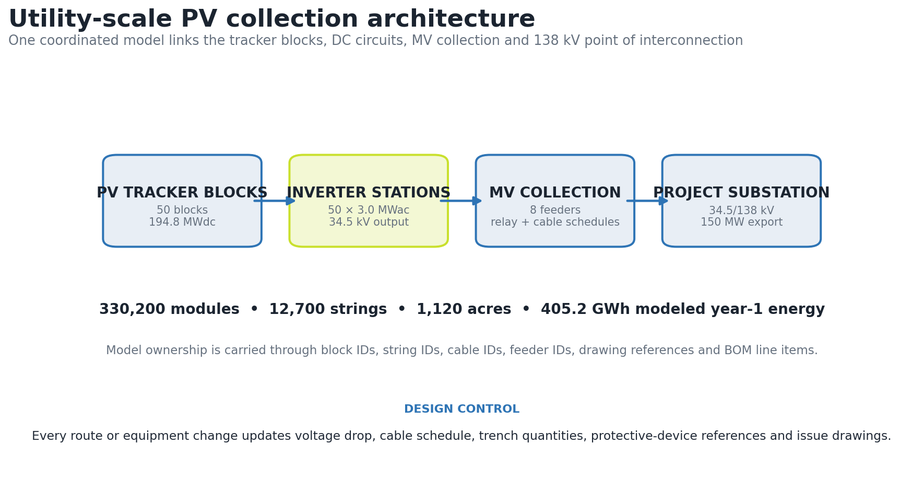

Utility-scale solar PV collection architecture from tracker blocks to project substation
Utility-scale PV collection architecture: one coordinated model links the tracker blocks, DC circuits, MV collection and 138 kV point of interconnection.

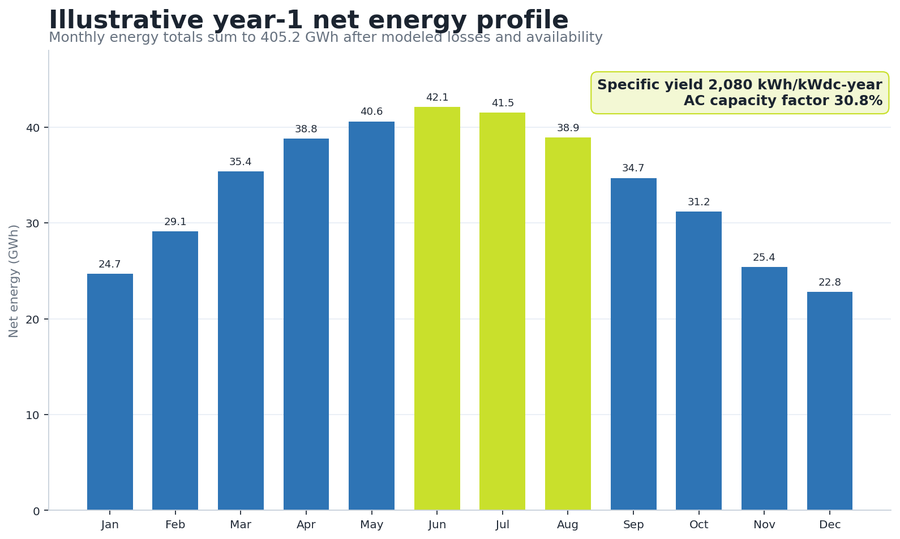

Illustrative year-1 net energy profile by month
Illustrative year-1 net energy profile: monthly totals sum to 405.2 GWh after modeled losses and availability, for a 2,080 kWh/kWdc-year specific yield and 30.8% AC capacity factor.

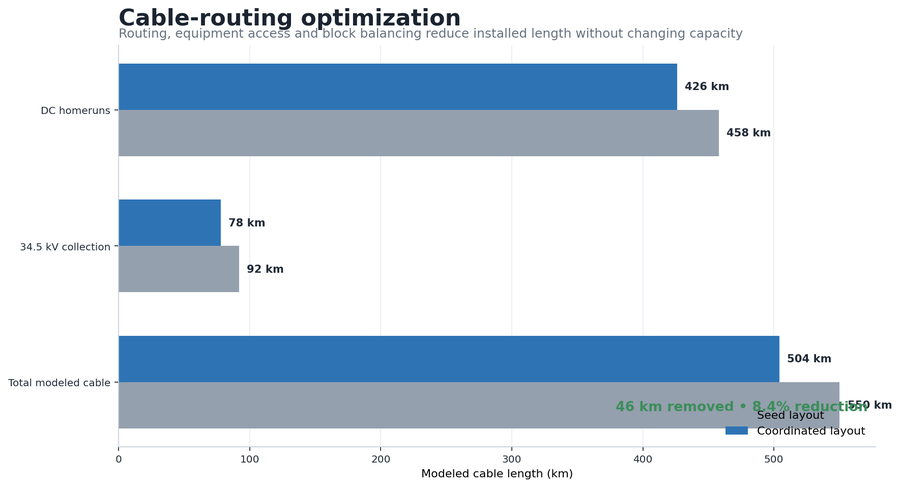

Cable-routing optimization chart, seed versus coordinated layout
