Pathworks Engineering
← Back to workFTTx & Telecom

Aerial FTTH design and pole make-ready analysis

A regional fiber overbuilder expanding through mixed investor-owned and cooperative pole territories across North Georgia suburban and rural corridors.

Aerial FTTH design and pole make-ready analysis
Input received
A pole survey export with coordinates, owner, height/class/species and condition data, measured communication attachments, span lengths and mid-span photos, and pole-owner application templates and batch limits.
Delivered
Aerial route plan sheets, a pole schedule with existing/proposed heights and dispositions, a photo index and missing-data report, a make-ready matrix, an owner-format pole-loading input workbook, and an attachment application drawing set.
Timeline
18 business days after receipt of a complete survey export and owner criteria.

A pole-by-pole evidence record separates clean attachment candidates from conditions that require transfer, rearrangement, guying review or replacement. The modeled review identifies 226 make-ready or data conflicts across 1,946 poles; design adjustments resolve 141 before application packaging, including 15 avoided pole-replacement candidates, reaching 92% first-submission readiness.

Poles analyzed
1,946
Aerial route
61.3 mi
Conflicts found
226
Turnaround
18 days

The engineering problem

The route crosses three pole-owner territories and includes older joint-use lines where pole tags, attachment ownership and measured heights are not consistently recorded. Some spans exceed the client's preferred length, several road crossings lack complete lowest-point measurements, and vegetation or equipment obscures field photographs. The objective is to separate clean attachment candidates from conditions that require transfer, communication-space rearrangement, guying review, replacement or structural analysis, rather than burying every exception inside a generic make-ready allowance. The work is organized around a pole-by-pole evidence record: clean poles move directly into owner application batches, while incomplete, conflicting or structurally sensitive poles stay on a named exception path.

Design parameters and first-principles checks

Route61.3 aerial miles across 1,946 poles; average sequential span approximately 166 ft
Premises2,410 planned passings
OwnershipThree pole-owner territories with separate schedule and exhibit rules
Conflict population226 make-ready or data conditions; 11.6% of analyzed poles
Design-resolved141 conditions addressed through route, height, terminal or slack-location changes
External action85 conditions assigned to field recheck, pole owner or licensed loading analysis
Application readiness92% first-submission readiness against the representative owner checklist
Avoided redesign15 pole-replacement candidates removed through design changes before application

Key design decisions

Each pole owner's adopted standards and templates are applied to its own territory; a single universal clearance or application rule is not assumed. Desktop screening identifies structural candidates, but screening is never represented as a licensed pole-loading certification. Conflicts are resolved by design where practical before owner batches are prepared, reducing preventable resubmittals and keeping remaining owner actions visible. Every application comment is tied to one pole ID, one sheet/schedule location, one disposition and one revision entry.

Pole-owner territory schedule

TerritoryPolesRoute miFlagged conditionsApplication approach
Owner A74223.488Four batches; owner CAD cover + pole schedule + photo index
Owner B66821.176Three batches; PDF plan + loading-input export
Owner C53616.862Three batches; joint-use worksheet + route exhibit
TOTAL1,94661.3226Ten controlled application batches

Conflict classification and disposition

Conflict classCountTypical Pathworks actionResidual owner
Attachment-space / height74Adjust proposed height, route or cable position where permittedPole owner for acceptance
Missing / ambiguous record48Issue pole-specific data request with photo/field referenceSurvey / field team
Guying / dead end36Flag angle/tension case and prepare guying inputOwner / licensed engineer
Road-crossing clearance29Review measured height and route or attachment alternativeOwner / field verification
Riser / equipment24Shift attachment, slack or terminal and document equipment conflictPole owner
Loading / replacement15Prepare loading candidate record; redesign where practicalLicensed loading analysis

QA steps and evidence

QA gateAcceptance testEvidence / result
InventoryPole IDs, coordinates, sequence and ownership are unique1,946 poles reconcile across GIS, schedule and batches
Photo coverageRequired views indexed to pole IDMissing/ambiguous images remain in the exception register
Clearance screenEvery crossing, riser, equipment pole, angle and dead end reviewed226 classified conditions
Loading inputsSpan, angle, cable and pole attributes complete for candidatesCandidate export plus missing-data flags
ApplicationPlan, pole schedule, photo and disposition matchTen batch checklists; 92% first-submission readiness
Peer reviewAll conflict poles + statistical clean-pole sampleReviewer initials and closed comment IDs

Revision record

RevisionTriggerChange madeControlled outcome
R0Route and terminal reviewMoved 18 terminals, changed 37 proposed heights and rerouted 2.1 mi141 conditions closed through design
R1Owner-format reviewApplied three owner title blocks, batch limits and loading fieldsTen application batches released; 85 external holds retained

Result and calculation trail

The modeled review identifies 226 make-ready or data conflicts across 1,946 poles. Design adjustments resolve 141 before application packaging, including 15 avoided pole-replacement candidates. The final package reaches 92% first-submission readiness against the representative owner checklist; 85 poles remain explicitly assigned to field, loading or owner resolution.

Pole density: 1,946 poles ÷ 61.3 route miles = 31.7 poles/mile. Conflict rate: 226 ÷ 1,946 = 11.6% of analyzed poles. Design resolution: 141 ÷ 226 = 62.4% of flagged conditions closed before application. First-submission readiness: 92% against the complete representative owner checklist, with every hold named by pole ID.

Pathworks processed 1,946 pole records and designed 61.3 miles of aerial FTTH across three ownership territories, separating clean attachment candidates from 226 make-ready, data and loading conditions and carrying each disposition into pole schedules and owner-format drawings.

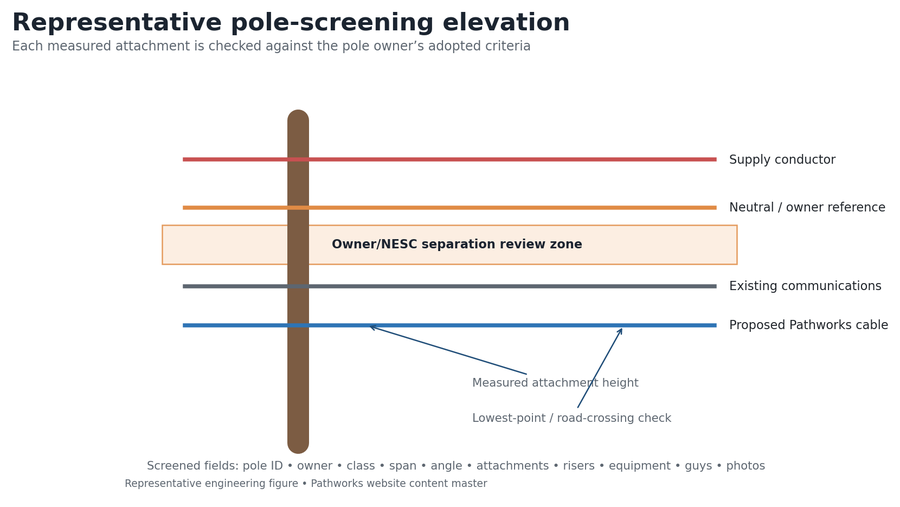

Representative pole-screening elevation with measured attachment data
Representative pole-screening elevation: the measured data and owner-specific separation checks used to classify a proposed communication attachment.

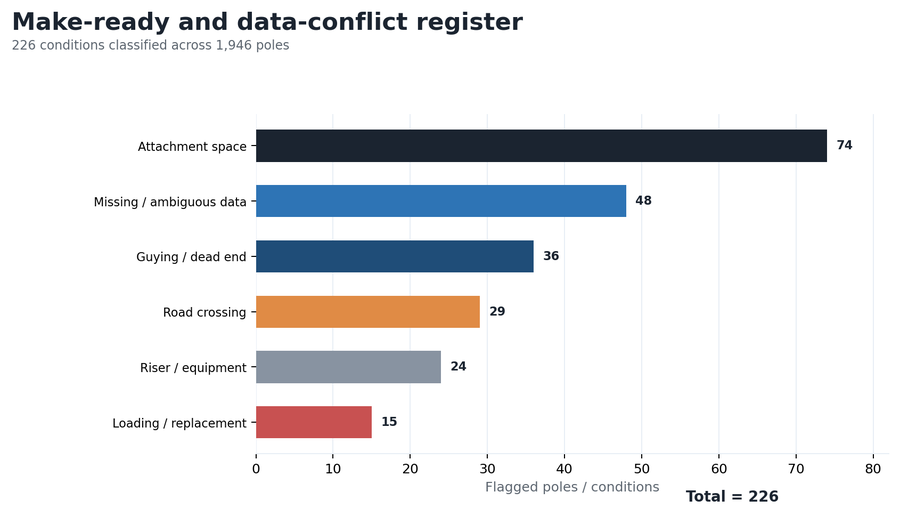

Make-ready and data-conflict register by classification
Make-ready and data-conflict register: 226 conditions are separated into actionable classes rather than reported as one undifferentiated make-ready total.

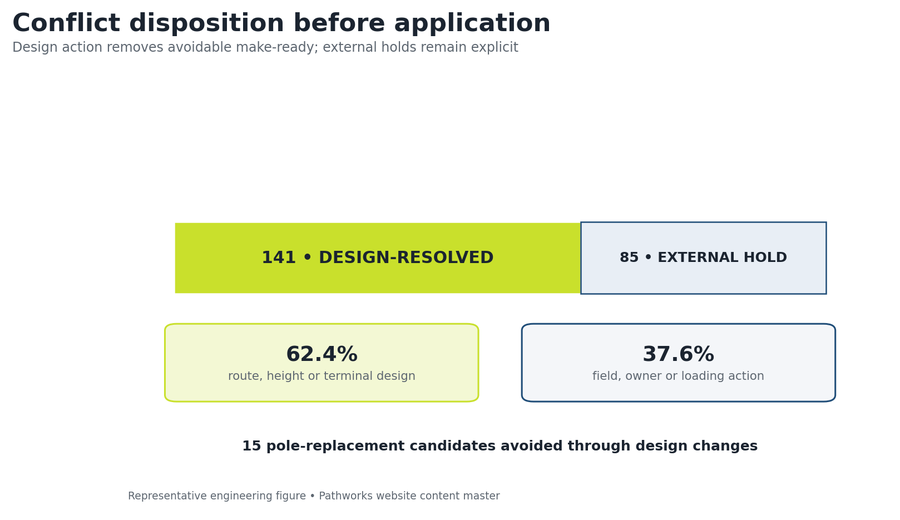

Conflict disposition split between design-resolved and external actions
Conflict disposition: 141 conditions are resolved through design; 85 remain explicitly assigned to field, owner or loading action.

Owner-application readiness gate result
Owner-application readiness: the final batch gate measures schedule, photo, drawing and disposition completeness and produces a 92 percent readiness result.
