Pathworks Engineering
← Back to workFTTx & Telecom

Underground FTTH and right-of-way permit design

A municipal broadband prime contractor preparing phased underground FTTH permit packages across Northern Colorado Front Range communities.

Underground FTTH and right-of-way permit design
Input received
A survey/design base with right-of-way and property lines, composite utility records with source date and confidence notation, roadway-owner jurisdiction and permit checklists, and the client's duct, handhole and spare-conduit criteria.
Delivered
Jurisdiction-indexed permit plan sets, a conduit/cable/handhole/bore schedule register, a GIS line/point package, a composite utility-conflict log, route-segment quantities and BOM, and a QA/revision/permit transmittal matrix.
Timeline
21 business days after receipt of the approved base, utility composite and jurisdiction checklist.

One connected network model is divided into nine jurisdiction-specific permit packages. The modeled design resolves 51 of 64 identified utility conflicts before permit issue, shortens the initial route by 1.9 miles, and the revised quantities indicate approximately $410,000 in avoided construction and restoration cost relative to the seed alignment.

Underground route
26.8 mi
Bore crossings
42
Permit sets
9
Modeled savings
$410k

The engineering problem

The build passes established subdivisions, commercial frontage and state-highway approaches where water, sanitary, storm, gas, electric and incumbent telecom records overlap. Available utility records carry different survey dates and quality levels, and several candidate handholes fall within driveways, drainage features or landscape zones. The permitting problem is to create jurisdiction-specific packages without fragmenting the network model: every reroute, bore-length change and handhole move must update the plan sheets, GIS, bore schedule, restoration quantities and BOM together, from the same controlled segment IDs.

Design parameters and first-principles checks

Underground route26.8 miles total: 17.6 mi trench/plow, 7.9 mi directional bore, 1.3 mi existing duct
Structures286 handholes; approximately 470 ft average access spacing on 25.5 mi of new route
Crossings42 road/driveway bore profiles and schedules
JurisdictionsNine permit packages across municipal, county and state roadway owners
Utility conflicts64 desktop conflicts; 51 resolved by route/structure change; 13 carried to SUE/field/agency action
Route optimizationSeed alignment reduced by 1.9 miles
Modeled avoidance$316k route reduction + $94k relocations/restoration = approximately $410k

Key design decisions

Composite utility records are used with source date and confidence status; record linework is never presented as survey-quality evidence. Handholes are moved away from driveways, drainage features, curb ramps and high-restoration surfaces before permit issue where the network geometry allows. Bore profiles are prepared for permit geometry and known constraints while final tooling, fluids, pullback and geotechnical design are left to the construction team and qualified specialists. One segment ID is carried from GIS through plan callout, permit sheet, quantity row and conflict entry so revisions propagate consistently.

Permit-package matrix

Roadway owner / areaPackagesRoute miBoresPrimary drawing controls
City North38.214ROW line, pavement cut, sidewalk/ADA, restoration
County corridors210.413ditch profile, driveway crossings, shoulder restoration
State highway approaches24.89stationing, bore profile, cover, traffic-control reference
Adjacent municipalities23.46local title block, details, permit quantities
TOTAL926.842One network model; jurisdiction-specific issue sets

Construction-method and quantity control

Method / assetQuantityDesign control
Trench / plow17.6 miSegment method, surface type, duct count and restoration category
Directional bore7.9 miBore ID, station limits, profile, owner, cover and known-utility notes
Existing conduit reuse1.3 miOwner evidence, duct availability and rodding/proofing requirement
Handholes286ID, size, station, surface, jurisdiction and connected segments
Bore crossings42Entry/exit, bore length, crossing type and permit sheet reference
Open conflicts13Location, source confidence, action, responsible party and issue status

QA steps and evidence

QA gateAcceptance testEvidence / result
ROW modelRoute and structures inside mapped permit limitsJurisdiction and property/ROW overlay check
Duct continuityNo orphan segments; pulling sections within client criteriaSegment-to-handhole trace and length report
CrossingsAll road/driveway bores carry profile and schedule ID42 bore IDs reconcile to sheets
UtilitiesEvery conflict has source, response and action owner51 resolved; 13 open
Permit completenessTitle block, notes, details, restoration and quantities match owner checklistNine signed internal QA checklists
QuantityGIS, schedules, sheets and BOM match26.8 mi / 286 handholes / 42 bores

Revision record

RevisionTriggerChange madeControlled outcome
R0Composite utility reviewMoved 31 handholes and rerouted 1.4 miForty-four conflicts closed; dependent schedules and quantities updated
R1Agency checklist reviewAdjusted six bore limits, restoration notes and 0.5 mi of alignmentNine owner-specific permit sets released; 13 external actions retained

Result and calculation trail

The modeled design resolves 51 of 64 identified utility conflicts before permit issue, shortens the initial route by 1.9 miles and packages the work into nine jurisdiction-specific sets. The revised quantities indicate approximately $410,000 in avoided construction and restoration cost relative to the seed alignment.

Route reduction: 28.7 seed miles − 26.8 final miles = 1.9 miles. Route savings: 1.9 mi × 5,280 ft/mi × $31.50/ft = $316,008. Avoided relocation/restoration allowance: approximately $94,000. Total modeled avoidance: $316,008 + $94,000 = $410,008, reported as approximately $410,000.

Pathworks developed 26.8 miles of underground FTTH design and divided the coordinated network into nine permit-ready packages: conduit routing, 286 handholes, 42 bore crossings, composite utility review, restoration quantities and a controlled exception log.

Underground construction-method plan by trench, bore and existing duct
Underground construction-method plan: the 26.8-mile route is classified into trench/plow, directional bore and existing-duct segments for permitting and quantity control.

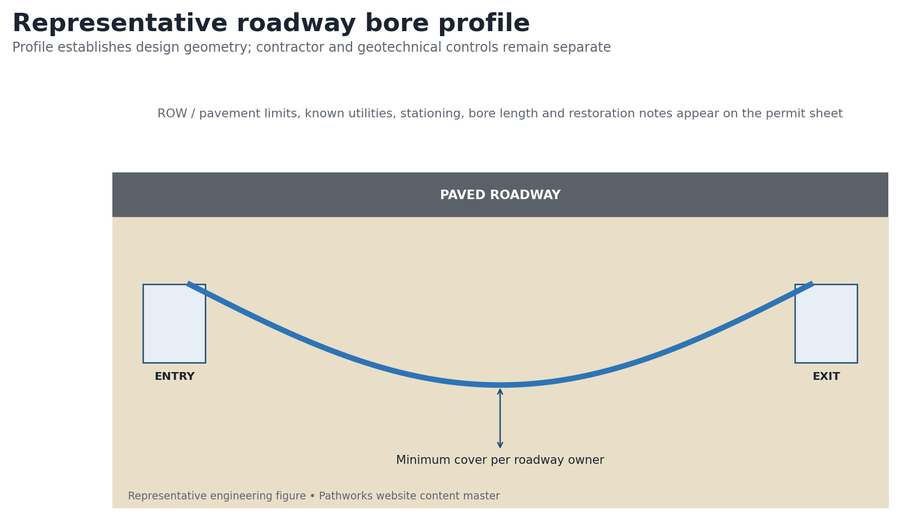

Representative roadway bore profile with cover and stationing
Representative roadway bore profile: the permit profile carries roadway limits, known utilities, cover criteria, stationing and entry/exit zones while keeping contractor means and methods outside design scope.

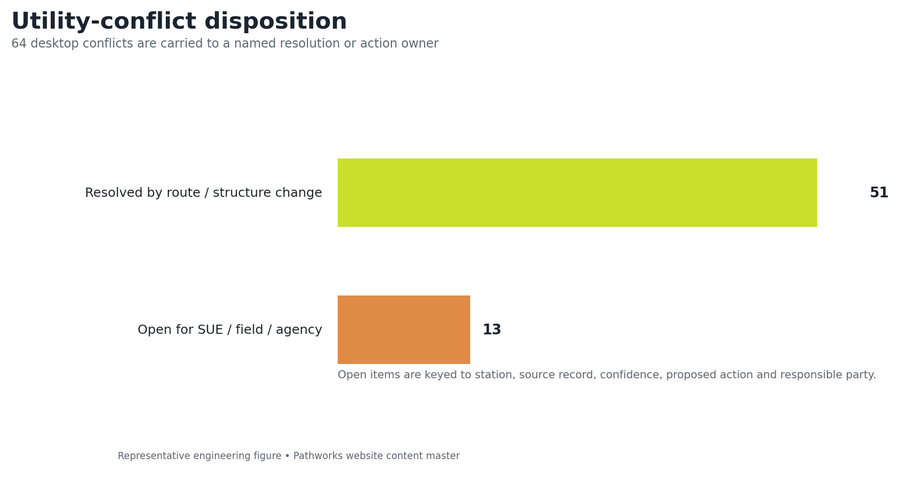

Utility-conflict disposition, resolved versus open
Utility-conflict disposition: 51 of 64 desktop conflicts are resolved in design; 13 remain named actions rather than implicit construction risk.

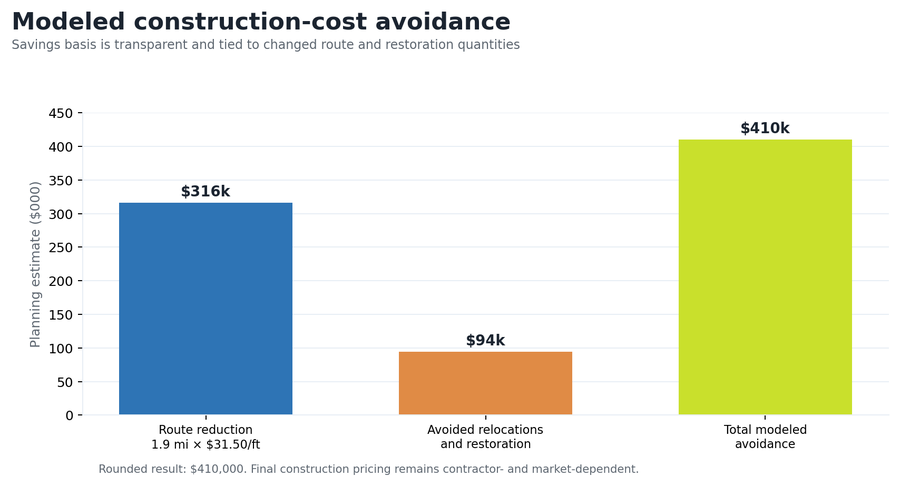

Modeled construction-cost avoidance breakdown
Modeled construction-cost avoidance: the approximately $410,000 result combines explicit route-footage reduction and avoided relocation/restoration allowances.
